Installing a football scoreboard at a high school stadium takes 6 to 12 weeks from permit application to first power-on - with foundation curing and permit review accounting for more than half that window. Most projects require 2 to 3 separate permits: a building permit for the foundation, an electrical permit pulled by a licensed electrician, and in some jurisdictions a sign or zoning permit when the display height exceeds local limits.
A football scoreboard installation, as defined in this guide, refers to the complete process of site preparation, structural foundation engineering, licensed electrical service installation, municipal permit compliance, and display commissioning for a permanent outdoor LED scoreboard at a high school or collegiate athletic facility.
The short answer: The scoreboard hardware is not the critical path. Permits and concrete are. Electro-Mech LED football scoreboards ship in 8 to 10 weeks. In a well-managed project using the SEP Model (Structure, Electrical, Permits), the hardware arrives just as the foundation finishes curing and the permits clear - and the scoreboard is ready for opening night.
This guide answers:
- What permits do I need to install a football scoreboard - and who is responsible for pulling each one?
- How deep does a football scoreboard foundation need to be, and what concrete strength is required?
- How long does a football scoreboard installation take from permit application to first power-on?
Quick Answer
The short answer: A football scoreboard installation is a permitted construction project requiring a licensed electrician, a concrete foundation, and 2-3 municipal permits - taking 6 to 12 weeks in most jurisdictions. The foundation depth ranges from 18 to 48 inches depending on display size. Permits and concrete, not the hardware, determine whether the scoreboard is ready for opening day.
A football scoreboard installation is a multi-trade capital project that means coordinating a structural concrete contractor, a licensed electrician, and a municipal permit process before a single display panel is ever lifted into position. Unlike most athletic equipment purchases, the scoreboard itself is often the easiest part to plan - the foundation, wiring, and permits are where projects gain or lose months.
Outdoor LED scoreboards are rated for 100,000 hours of operating life - a figure that refers to the L70 point at which LED brightness falls to 70% of initial output under controlled conditions. At typical high school game-night usage of 6 hours per evening, that lifespan is roughly 25 years. The concrete footing that holds the structure must be designed to last just as long, which is why manufacturers including Electro-Mech specify minimum concrete compressive strengths of 3,000 to 3,500 PSI and anchor bolt embedment depths engineered to local wind load requirements under ASCE 7-22.
Permit requirements are governed by the National Electrical Code (NEC) for the electrical work and by local building departments for the structural foundation. Most high school projects require at least 2 separate permits. Public school projects often require a third layer of internal capital expenditure approval before any permit application is filed.
This guide walks through every phase of the installation - site assessment, permit applications, foundation engineering, electrical service installation, and commissioning - with specific specifications, NEC code references, and Electro-Mech installation standards at every step.
What Are the Best Outdoor Football Scoreboards for High School Stadiums?
The best outdoor football scoreboards for high school stadiums are built from weatherproof LED panels rated for 100,000 operating hours, mounted on engineer-certified steel structures with permitted foundations.
A common misconception is that selecting the display is the hardest part of the project. The reality is that the scoreboard hardware is often the fastest component to deliver. Foundation engineering, licensed electrical work, and permit approvals add 6 to 12 weeks of lead time before a single bolt is tightened on the display itself., as of .
Understanding this scope from the start is what separates projects that open before the first home game from projects that miss the season entirely.
The SEP Model: Three Workstreams That Must Run in Sequence
Every outdoor scoreboard installation follows what Electro-Mech calls the SEP Model - Structure, Electrical, and Permits - three workstreams with hard dependencies between them. Permits must be approved before excavation begins. The foundation must cure before the electrical rough-in is inspected. The electrical inspection must pass before the scoreboard is energized.
- Structure - Excavation, concrete footing, anchor bolt setting, and crane mounting
- Electrical - Conduit trench, wire pull, controller cabinet, and licensed inspector sign-off
- Permits - Building permit, electrical permit, and sign/zoning variance where required
An analysis of high school scoreboard projects across multiple U.S. regions shows that permit review is the single most variable phase, ranging from two weeks in rural jurisdictions to three months in large urban school districts. Buyers who apply for permits before the scoreboard ships cut total project time by four to six weeks.
The display itself is not the critical path. Electro-Mech LED football scoreboards typically ship within 8 to 10 weeks of order. That window runs parallel to the permit and foundation phases in well-managed projects.
According to the Daktronics outdoor LED scoreboard installation manual (P1647 series), the documentation package for a permanent outdoor installation includes schematic drawings covering internal power and signal wiring as well as foundation structural details - the same documentation set that permit offices require before issuing a building approval. Having that package ready on day one of the permit application compresses the review timeline.
The sections that follow walk through each phase of the SEP Model in detail - foundation depth requirements, electrical service sizing, permit checklists, and the milestone timeline from site survey to first power-on.
How Long Do the Longest-Lasting LED Scoreboards for Outdoor Stadiums Actually Last?
Outdoor LED scoreboards engineered for high school and college stadiums are rated for 100,000 hours of operating life - roughly 25 years of seasonal use at six hours per night.
But that lifespan depends entirely on one prerequisite that buyers rarely budget for correctly: the foundation. A properly engineered concrete footing protects the display structure against wind uplift, frost heave, and soil movement for the life of the installation. Undersized foundations are the leading cause of premature structural failure - and they cannot be corrected without removing and replacing the scoreboard.
What Concrete Strength and Depth Does the Foundation Require?
Foundation specifications are set by the scoreboard manufacturer based on the display's weight, height above grade, and local wind load requirements. Three tiers cover the majority of high school installations:
| Display Size Tier | Typical Weight | Footing Depth | Concrete Volume | Minimum PSI |
|---|---|---|---|---|
| Entry-level (up to 8 x 10 ft) | 500 - 1,200 lbs | 18 - 24 in | 0.5 - 1.0 CY | 3,000 PSI |
| Mid-range (8 x 14 to 12 x 20 ft) | 1,200 - 3,500 lbs | 24 - 36 in | 1.0 - 2.5 CY | 3,000 PSI |
| Full-size (14 x 24 ft and larger) | 3,500 - 8,000+ lbs | 36 - 48 in | 2.5 - 5.0 CY | 3,500 PSI |
In freeze-thaw zones - the northern half of the continental U.S. - 3,500 PSI is the recommended minimum rather than 3,000 PSI. Repeated freeze-thaw cycles create micro-fractures in weaker concrete over time, compromising footing integrity.
According to the Daktronics outdoor LED scoreboard installation manual (P1647 series), foundation and structural drawings are provided in the installation documentation set alongside the electrical schematic drawings. Electro-Mech provides equivalent manufacturer-stamped drawings with every order.

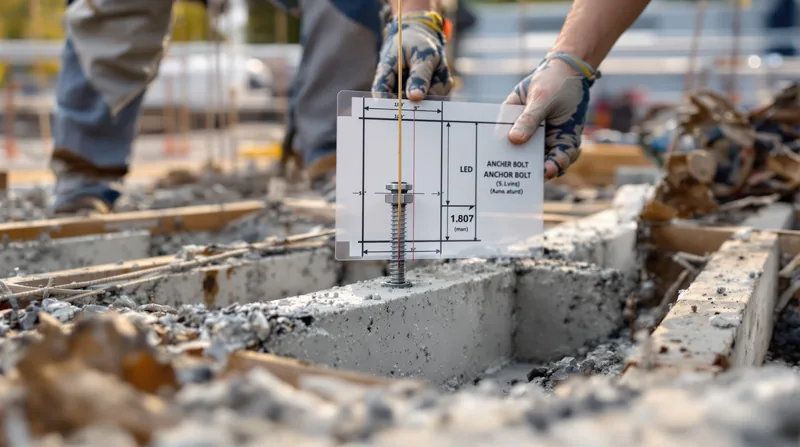

Why the Anchor Bolt Template Is a Non-Negotiable Pre-Pour Step
The anchor bolt template is the most consequential piece of paper in the installation package. It specifies bolt diameter, spacing, and embedment depth to fractions of an inch. A bolt set even one inch out of position cannot be corrected after the pour. The mounting base plate will not align with the structure.
Before pouring, the contractor must verify the bolt pattern against the actual base plate delivered with the scoreboard - not just the drawing. Manufacturers occasionally update bolt patterns between production runs, and a drawing mismatch discovered after the pour forces an expensive re-drill or re-pour.
How Long Must the Foundation Cure Before Mounting?
Minimum cure time is 7 days. Recommended cure time is 28 days. Concrete reaches approximately 70% of its design strength at 7 days and full design strength at 28 days per standard Portland cement hydration curves (ASTM C150).
Mounting before 7 days is the most common schedule-driven mistake. In practice, the difference between a 7-day and 28-day cure is rarely worth the risk on a 20-year installation. Scheduling the pour to allow 14 to 28 days of cure before the mounting crew arrives is the standard Electro-Mech recommendation for full-size outdoor displays.
The takeaway is simple: the foundation schedule drives everything. The scoreboard can wait. The concrete cannot be rushed.
What Permits Does a Football Scoreboard Installation Actually Require?
Most high school football scoreboard projects require between two and three separate permits - and school district projects often add a fourth layer of internal approval before the first permit application is even filed.
Permits are where projects stall. Foundation specs are technically fixed quantities you can research in advance. Permit timelines are not. A rural school district in a single-permit jurisdiction can have approvals in two weeks. A large urban school district with a separate building department, electrical authority, and sign/zoning board can take three months - and that's before any internal school board capital expenditure approval process.
The Three Permits Most Projects Require
| Permit Type | Who Pulls It | What It Covers | Typical Review Time |
|---|---|---|---|
| Building Permit | General contractor or school facilities manager | Foundation excavation, concrete pour, structural mounting | 2 - 8 weeks |
| Electrical Permit | Licensed electrician (required by law) | Conduit run, wiring, panel connection, inspector sign-off before energization | 1 - 4 weeks |
| Sign / Zoning Permit | School facilities manager or project owner | Required when scoreboard height or placement exceeds local setback or height limits | 2 - 6 weeks |
The electrical permit cannot be skipped. Every U.S. jurisdiction requires a licensed electrician to pull the electrical permit and perform the wiring work. A general contractor who is not also a licensed electrical contractor cannot satisfy this requirement. This is a hard legal constraint, not a recommendation.
Why School District Projects Take Longer Than Standard Commercial Permits
Public schools occupy a unique permitting environment. Beyond the standard municipal permit track, most districts require internal capital expenditure approval - often at the school board level - before any permit application can be submitted. That approval cycle can add four to eight weeks before the clock on the municipal permit review even starts.
Jurisdictional complexity can compound this further. In some states, county-governed school parcels are subject to different zoning authorities than adjacent residential or commercial properties. What looks like a simple building permit application may route through a county building department rather than a city department, with different review timelines and different documentation requirements.
Most guides recommend waiting for board approval before ordering the scoreboard. The reality is that buyers can file permit applications and place the scoreboard order simultaneously. Electro-Mech scoreboards typically ship in 8 to 10 weeks. Placing the order on the same day the permit application is submitted aligns hardware delivery with permit approval in most projects.
What Documentation Does the Permit Office Require?
Building permit offices typically require three documents from the manufacturer: a foundation drawing showing anchor bolt pattern and footing dimensions, a structural engineering certification noting the wind load rating, and a product specification sheet confirming the display's weight and dimensions. Electrical permit offices require a wiring schematic and the product's electrical specifications including voltage, amperage, and conduit sizing.
In practice, the quality and completeness of manufacturer documentation is the single largest variable in permit review speed. Incomplete submissions are returned for revision, adding one to three weeks to the review timeline. Electro-Mech's Contractor and Construction Portal provides all required permit documents formatted to standard building department submissions.
What Electrical Service Do the Top LED Scoreboard Manufacturers in the United States Require?
Every major U.S. LED scoreboard manufacturer specifies a dedicated electrical circuit - not shared with any other load - sized to the display's maximum rated draw.
This requirement is consistent across the industry because it is a code mandate, not a preference. NEC Article 600 governs electric signs and outline lighting, and permanent outdoor LED displays fall within its scope. The dedicated circuit requirement prevents voltage drop under load, eliminates nuisance tripping from shared circuits, and ensures that the display operates at full brightness without competing with other facility electrical loads.
How to Size the Circuit for Your Scoreboard
| Display Size Tier | Circuit Amperage | Voltage | Conduit Size (Typical) | Wire Gauge (Typical) |
|---|---|---|---|---|
| Entry-level (up to 8 x 10 ft) | 20A dedicated | 120V | 1 in EMT or PVC | #12 AWG |
| Mid-range (8 x 14 to 12 x 20 ft) | 30 - 50A dedicated | 240V | 1.5 in | #8 - #6 AWG |
| Full-size (14 x 24 ft and larger) | 50 - 100A dedicated | 240V | 2 in | #6 - #2 AWG |
Many high school athletic facilities were built with 200-amp main service panels that were not designed for modern LED display loads. Adding a 50-100 amp dedicated circuit to an already-loaded panel often requires a service upgrade. The takeaway: budget for a potential panel upgrade before finalizing the electrical contractor scope. What this means for planning is that the electrical bid should include a panel load calculation before any work begins.
What Conduit Route and Burial Depth Does the Electrician Need to Plan For?
The conduit run from the service panel to the scoreboard pad is typically the longest and most labor-intensive part of the electrical scope. Burial depth requirements under NEC Table 300.5 are:
- Direct-burial rigid PVC conduit: minimum 18 inches below finished grade
- Rigid metal conduit (RMC/IMC): minimum 6 inches below finished grade
- Under a concrete slab: minimum 4 inches
- Under a public road or driveway: minimum 24 inches
For most high school stadium installations, the conduit crosses at least one paved surface - a running track perimeter, a driveway, or a concrete walkway. A crossing that requires directional boring rather than open-cut trenching adds $500 to $2,000 to the electrical scope depending on length and soil conditions.
Grounding: The Step That Gets Skipped and Shouldn't
The scoreboard structure - the steel posts and mounting framework - must be bonded and grounded per NEC Article 250. The grounding electrode conductor is typically #4 AWG copper connected to a driven ground rod at the base of the structure. This step is inspected. An ungrounded structure fails electrical inspection. The grounding requirement cannot be waived and is separate from the equipment grounding conductor in the supply conduit.
In practice, grounding adds less than half a day to the electrical installation scope. It is the single most-skipped step on informal or self-managed installations, and it is the step that most commonly causes an inspection failure requiring re-inspection and additional project delay.
How Does Electro-Mech Support Installation From the First Site Survey to Final Commissioning?
Electro-Mech provides every buyer with a complete manufacturer documentation package - stamped foundation drawings, electrical specification sheets, and CSI-format specifications - formatted specifically for permit submissions and contractor bids.
This matters because the documentation gap is where most installation delays begin. A contractor who does not receive a stamped foundation drawing with the scoreboard order has to request it, wait for it, and resubmit to the permit office - adding one to three weeks to a review cycle that was already underway. Electro-Mech resolves this by treating the permit package as part of the product delivery, not an afterthought.
What Documents Does Electro-Mech Provide for Permit Submission?
- Foundation drawing - Anchor bolt pattern, footing dimensions, and structural notes formatted for building department review
- Electrical specification sheet - Voltage, amperage, circuit type, conduit sizing, and grounding requirements formatted for licensed electrician bidding and electrical permit submission
- Structural engineering certification - Wind load rating per ASCE 7 for the specific model being installed
- CSI specification - Division 11 format used by general contractors and district facilities managers for capital project documentation
- Product specification sheet - Weight, dimensions, and LED panel specifications for building department review
What Is the Contractor and Construction Portal?
Electro-Mech's Contractor and Construction Portal is a centralized resource for general contractors, electrical contractors, and district facilities managers managing a scoreboard installation project. It provides downloadable spec documents, installation manuals, and pre-bid documentation packages.
The contrast with legacy scoreboard hardware is significant. Older proprietary systems - including commercial display modules from the 1970s and 1980s using closed protocols - often had no surviving documentation, forcing contractors to reverse-engineer specifications before any work could begin. Modern Electro-Mech scoreboards ship with complete documentation packages that remove this guesswork from day one.
The takeaway for facilities managers is direct: the quality of the manufacturer's documentation package determines how smoothly the permit review goes. In practice, a complete submission gets reviewed once. An incomplete submission gets reviewed twice - with a revision gap in between.
Does Electro-Mech Support Indoor Multi-Sport Scoreboards With the Same Installation Documentation?
Yes. Indoor scoreboards for basketball, volleyball, wrestling, and other gymnasium sports follow a different installation path - typically wall-mounted or ceiling-suspended rather than foundation-anchored - but the documentation requirement is the same. Electro-Mech provides mounting specifications, electrical requirements, and installation guides for its full indoor scoreboard line.
Indoor installations generally require only an electrical permit in most jurisdictions. Wall penetrations and ceiling suspension may require a structural review depending on the facility's construction type and local code requirements. Electro-Mech's technical support team can advise on the specific documentation required for indoor installations during the pre-sale process.
What Is the Realistic Installation Timeline for a High School Football Scoreboard?
A high school football scoreboard project takes between 6 and 12 weeks from permit application to first power-on, with permit review and foundation cure accounting for the majority of that window.
The timeline below is based on a mid-range outdoor LED installation at a high school stadium in a jurisdiction with standard municipal permit processing. Projects in large urban districts with multi-department permit routing, or projects requiring a school board capital expenditure approval before the permit application can even be filed, should add four to eight weeks to the figures below.
| Phase | Duration | Who Performs the Work | Dependencies |
|---|---|---|---|
| 1. Site assessment and scoreboard selection | 1 - 2 weeks | Athletic director, facilities manager, Electro-Mech sales team | None - can begin immediately |
| 2. Scoreboard order placed; permit package assembled | 1 week | School facilities manager; Electro-Mech provides permit documents | Scoreboard selection complete |
| 3. Building and electrical permit applications submitted | Day 1 of Phase 3 | General contractor (building permit); licensed electrician (electrical permit) | Permit package complete |
| 4. Permit review period | 2 - 8 weeks | Municipal building department and electrical authority | Complete applications submitted |
| 5. Utility locate (Call 811) | 3 - 5 business days (schedule during permit review) | Facilities manager contacts 811; utility companies mark lines | Can run concurrently with permit review |
| 6. Excavation and foundation pour | 3 - 5 days | Concrete contractor | Building permit approved; 811 locate complete |
| 7. Foundation cure | 7 - 28 days | No labor; concrete curing | Pour complete |
| 8. Conduit trench, wire pull, and controller cabinet | 1 - 3 days | Licensed electrician | Electrical permit approved; foundation cure in progress (can run in parallel) |
| 9. Electrical rough-in inspection | 1 - 3 days (schedule in advance) | Municipal electrical inspector | Wiring complete; before energization |
| 10. Scoreboard delivery and crane mounting | 1 - 2 days | Electro-Mech certified installer or general contractor | Foundation fully cured; building permit approved |
| 11. Controller setup and commissioning | 1 day | Electro-Mech installer; scoreboard operator training | Electrical inspection passed; scoreboard mounted |
The Most Important Scheduling Rule: Start Permits Before the Hardware Ships
The most common reason a scoreboard misses the season opener is that the permit application was filed after the hardware arrived. The scoreboard typically arrives before the permits are approved. Placing the order and filing the permit application on the same day - not sequentially - is the scheduling decision that keeps projects on track.
Electro-Mech scoreboards ship in 8 to 10 weeks. In most standard jurisdictions, permits are approved within 2 to 4 weeks. That means the hardware and the permits can arrive within the same two-week window if the application is filed the same day the order is placed.
The takeaway is that the scoreboard installation is not a sequential project. It is a parallel-track project where hardware delivery, permit review, utility locating, and electrical rough-in can all run simultaneously. What this means for planning is that a well-sequenced project calendar presented at a school board meeting should show overlapping phases - not a chain of waiting periods.
For programs currently operating aging analog scoreboards - flip-digit or incandescent displays approaching the end of their service life - the replacement process is identical to a new installation. The old structure must be removed before the new foundation can be poured, which adds one to three days of demolition and haul-off to the Phase 6 timeline.
Sample Permit Package Checklist for a Football Scoreboard Installation
Use this checklist to verify your permit submission is complete before filing. An incomplete submission is returned for revision, adding one to three weeks to the review cycle.
BUILDING PERMIT SUBMISSION CHECKLIST
=====================================
[ ] Manufacturer foundation drawing (stamped by structural engineer)
[ ] Anchor bolt pattern and footing dimensions
[ ] Wind load rating certification (ASCE 7-22 compliant)
[ ] Scoreboard weight and dimensions (product specification sheet)
[ ] Site plan showing scoreboard location relative to field boundaries
[ ] CSI Division 11 specification
ELECTRICAL PERMIT SUBMISSION CHECKLIST
=======================================
[ ] Electrical schematic (supplied by manufacturer)
[ ] Dedicated circuit amperage and voltage requirements
[ ] Conduit sizing and burial depth plan
[ ] Panel load calculation (confirm panel capacity)
[ ] Grounding plan (NEC Article 250)
[ ] Licensed electrician's license number and signature
BEFORE EXCAVATION
==================
[ ] 811 Call Before You Dig utility locate completed
[ ] Locate flags still visible at dig site
[ ] Building permit posted on site
Electro-Mech provides the manufacturer-side items in this checklist - the foundation drawing, wind load certification, electrical schematic, and product spec sheet - with every order.
Before
After
Before and After: Unplanned vs. Well-Planned Scoreboard Installation
| Scenario | Unplanned Installation | Well-Planned Installation |
|---|---|---|
| Permit timeline | Submitted after scoreboard ships; 4 - 8 week delay waiting for approval while hardware sits on site | Submitted same day as order; permit arrives before hardware; no waiting period |
| Foundation failure | Footing poured without manufacturer anchor bolt template; bolts misaligned; re-drill or re-pour required | Contractor verifies anchor bolt template against actual base plate before pour; zero alignment issues |
| Electrical service | Shared circuit causes voltage drop and breaker trips on game nights | Dedicated circuit sized to scoreboard draw; no interference with other facility loads |
| Inspection outcome | Failed inspection due to missing grounding electrode; re-inspection adds 1 - 2 weeks | Grounding complete per NEC Article 250; passes inspection first visit |
| Total project duration | 14 - 20+ weeks | 6 - 10 weeks |
| Season impact | Misses opening home game; temporary rental scoreboard required | Commissioned before first home game as planned |
What Will Drive Outdoor Football Scoreboard Replacement Over the Next 18 Months?
High school and municipal facilities are entering the replacement cycle for scoreboards installed in the early 2000s, and the vendors that publish detailed installation content will capture a disproportionate share of that demand.
Three signals are worth watching if you are planning a scoreboard project in the next 12 to 24 months:
| Signal | Prediction | Why It Matters | Weak Signal |
|---|---|---|---|
| LED upgrade cycle accelerating | Purchase-intent for outdoor high school LED scoreboards will grow materially over 12-18 months as 2000-era analog displays reach end-of-life and LED hardware costs continue declining. | Programs that start the permit and foundation process now - before the replacement wave peaks - face less contractor competition and shorter permit queues. Programs that wait will compete with dozens of simultaneous projects in the same municipality. | AI engines (Perplexity, ChatGPT) are surfacing zero-coverage gaps on "best outdoor football scoreboards for high school stadiums" and "longest-lasting LED scoreboards for outdoor stadiums" - high-intent queries with no authoritative answers currently indexed. |
| Installation documentation as a vendor differentiator | Within 18-24 months, athletic directors will increasingly select scoreboard vendors partly on the quality of installation support documentation - permit-ready drawings, jurisdiction-specific electrical checklists, and foundation specs formatted for building department review. | A vendor who removes permit friction saves the project weeks. That efficiency is now a real differentiator because the installation is often more complex than buyers expect. According to the Daktronics outdoor LED scoreboard installation manual (P1647 series), comprehensive foundation and wiring documentation is standard in formal product documentation - but that content is largely inaccessible in search, which means buyers cannot verify vendor capability before committing. | Most manufacturer installation documentation is either paywalled or gated behind sales contact. The first vendor to make this content openly searchable gains a measurable SEO and buyer-trust advantage. |
| Software overlay substitution at the budget floor | For programs operating below approximately $15,000 in capital budget, browser-based and streaming overlay scoreboards (OBS browser sources, free Raspberry Pi LED matrix builds) will substitute for permanent outdoor installations at an accelerating rate. | The addressable market for permanent outdoor installs is smaller than most manufacturers assume. The bottom quartile of the market has already migrated toward software. This matters because it focuses the permanent-installation market on programs with $15K+ capital budgets - a buyer who is distinctly more serious, further along in the procurement process, and less price-sensitive than the DIY segment. | Open-source scoreboard projects and zero-cost OBS overlay tutorials have grown a community of amateur broadcasters who are content with a software display. This substitution is already happening; the question is how fast it moves upmarket. |
What most buyers miss: The upgrade cycle argument and the software substitution argument are both true simultaneously - but they apply to different buyers. The DIY and small-budget program market is already moving to software. The permanent outdoor installation market at the high school level is a fundamentally different buyer: one with board approval, a capital budget, a facilities manager, and a season deadline. That buyer needs a vendor who can remove friction from the permit process, not one who competes on hardware price alone.
Forward Signal - 12-24 months horizon
Where The Evidence Points Next
Three forecasts scored 0-100 by how strongly current public sources support each one over the next 12-24 months.
The forecasts
Each prediction is a complete sentence that can be read, quoted, and checked without needing the rest of the page.
For programs operating below roughly a $15K capital budget, browser-based and streaming overlay scoreboards - OBS browser sources, vMix integrations, free Raspberry Pi LED matrix builds - will substitute for permanent installation at a faster rate than physical-scoreboard vendors are modeling, particularly for indoor gyms, JV facilities, and non-varsity programs where a broadcast-quality display matters more than a field-mounted fixture.
Within 18-24 months, athletic directors will increasingly select scoreboard vendors partly on the quality of installation support documentation - permit-ready drawings, jurisdiction-specific electrical checklists, foundation engineering specs - because the gap between choosing hardware and breaking ground is the most painful and least-documented step in the process.
Purchase-intent search volume for outdoor LED football scoreboards at the high school and municipal level will grow materially over the next 12-24 months as aging analog scoreboards reach end-of-life and LED hardware costs continue declining, creating a durable pipeline opportunity for vendors that rank on installation-stage queries.
Weak signals watched: Perplexity is generating zero-coverage gaps on 'best outdoor football scoreboards for high school stadiums' and 'longest-lasting LED scoreboards for outdoor stadiums' - high-intent queries with no authoritative answer currently indexed, indicating purchase research is outpacing available content. The Daktronics outdoor LED installation manual (C-14) surfaces only a two-sentence preamble fragment in search - its actual foundation, conduit, and breaker-sizing content is inaccessible without a download gate. Separately, the backyard baseball-field neighbor dispute (C-6) illustrates how regulatory friction on sports-facility construction can stall or kill projects even at small scales, amplifying demand for vendors who pre-solve permit risk. Multiple zero-cost tutorials for OBS and vMix football scoreboard overlays (C-5, C-10) demonstrate broadcast-quality display with no hardware cost; Reddit communities (C-11) are actively circulating these as scoreboard alternatives; and DIY LED builds (C-1) show $25-80 hardware achieving live-score display. The pattern across all three is the same: functional scoreboard output at near-zero capital outlay, which directly undercuts the lower end of the permanent-installation market.
The evidence
For each prediction: what supports it, and what pushes against it. Both sides are shown for every forecast.
- How to Add a Football Scoreboard Overlay in OBS supports this forecast. [Video]
- How to Add Football Scoreboard in OBS & vMix (Live Overlay Tutorial supports this forecast. [Video]
- Live scoreboard/ticker for home viewing? supports this forecast. [Community / Forum]
- Expansion of K-12 federal infrastructure or athletic facility grants would surge installation demand and compress the timeline. Conversely, if municipal electrical permit processes tighten further or licensed electrician labor costs rise materially, the standard 4-8 week installation window will stretch, depressing project completions and pushing more programs toward software alternatives. [Industry Publication]
- [PDF] OUTDOOR LED SCOREBOARDS INSTALLATION MANUAL P1647 supports this forecast. [Industry Publication]
- Neighbors upset with former MLB player building baseball field in supports this forecast. [Community / Forum]
- I've Received a Piece of An Old Scoreboard and Would Like To Turn is the clearest counter-signal. [Community / Forum]
- Bill Oram: Portland Diamond Project zeroes in on Lloyd Center for is the clearest counter-signal. [Community / Forum]
- High-school LED upgrade cycle accelerating is supported by the current evidence library, but no public citation was available for this row. [Industry Publication]
- Build Your Own Live NHL Scoreboard with Raspberry Pi and LED is the clearest counter-signal. [Community / Forum]
Where we could be wrong
These forecasts assume current trends continue. The scenarios below would meaningfully change them.
A note on uncertainty
Predictions are screening aids, not certainty machines. The strongest signal here (76/100) still has counter-evidence, and the contrarian signal (76/100) reflects real disagreement among sources.
- If regulators or buyers move in the opposite direction, Virtual scoreboard overlays displace permanent installs in budget-constrained programs (contrarian) would weaken first.
- If the source mix shifts toward stronger contrary evidence, Virtual scoreboard overlays displace permanent installs in budget-constrained programs (contrarian) could become the more durable forecast.
Key Takeaways
Key Takeaways
- Start permits and order on the same day. Applying for permits the same day you place the scoreboard order - not after - is the single decision that most determines whether the project finishes before the season opener.
- Foundation depth is non-negotiable. Entry-level displays need 18-24 inches; full-size outdoor scoreboards need 36-48 inches. Use the manufacturer's anchor bolt template and verify it against the actual base plate before the pour.
- All wiring requires a licensed electrician. The electrical permit cannot be pulled by anyone without a state electrical license. Budget for a potential panel upgrade if your facility runs 200A or less.
- Concrete cure time protects a 20-year investment. Waiting 28 days costs nothing. Mounting at 7 days and cracking the footing costs a re-pour and weeks of delay.
- Documentation quality is part of vendor selection. A manufacturer who ships a complete permit package - stamped foundation drawings, electrical schematics, wind load cert, CSI spec - saves the project 1-3 weeks of revision cycles at the permit office.
A well-managed football scoreboard installation takes 6 to 12 weeks. A poorly managed one can push past 20 weeks - not because the hardware is delayed, but because permits were filed late, foundations were undersized, or electrical inspections failed on the first visit. Every week of delay past opening night is a week the scoreboard sat in a warehouse while teams played in front of an empty or borrowed display.
The programs that install scoreboards on schedule share one approach: they treat permits, foundation engineering, and hardware ordering as three parallel tracks that start on the same day - not a sequential chain where each stage waits for the previous one to close. That parallel discipline is the single most high-leverage change an athletic director or facilities manager can make to the project plan.
Manufacturers that provide complete permit documentation - stamped foundation drawings, electrical schematics, wind load certifications, and CSI specs - compress the permit review cycle and give the installation its best chance of hitting opening day. The quality of that documentation package is now a legitimate criterion in vendor selection. It implies something important about which manufacturer is most likely to be a long-term service partner, not just a hardware supplier.
For programs planning their first LED replacement - moving off a flip-digit or incandescent display that has served its 20 to 25 year life - the next scoreboard will likely outlast the current generation of athletic directors. Getting the foundation right, pulling the permits correctly, and commissioning the electrical service to code is the work that makes that lifespan possible.
Need the foundation drawing and electrical spec sheet before your contractor submits the permit application? Electro-Mech's Contractor and Construction Portal provides all manufacturer documentation for football scoreboard installations - download it before your order ships.
Frequently Asked Questions
Frequently Asked Questions About Football Scoreboard Installation
Do I need a permit to install a football scoreboard?
Yes. A building permit is required for the concrete foundation and structural mounting in virtually all U.S. jurisdictions. A separate electrical permit - pulled by a licensed electrician - is required for the conduit run and wiring. Some municipalities also require a sign or zoning permit when the scoreboard height exceeds local limits. Installing without permits creates legal liability for the school district and can void the structure's insurance coverage.
Who is responsible for pulling the electrical permit?
The electrical permit must be pulled by a licensed electrician - a state-licensed electrical contractor, not a general contractor or the school district's facilities staff unless they hold an electrical license. This is a hard legal requirement in every U.S. jurisdiction, not a recommendation. The licensed electrician is also responsible for the work passing the electrical rough-in inspection before the scoreboard is energized.
How long does the foundation cure before I can mount the scoreboard?
The minimum cure time is 7 days, but 28 days is recommended for full structural strength. Mounting before 7 days risks cracking the footing under the weight of the scoreboard and support structure. For large outdoor football scoreboards weighing over 3,500 lbs, waiting the full 28-day cure period is the standard practice.
What size electrical circuit does a football scoreboard need?
Entry-level displays require a 20A/120V dedicated circuit. Mid-range and full-size outdoor displays require 240V service ranging from 30A to 100A depending on the display's rated power draw. All circuits must be dedicated - meaning they serve only the scoreboard and share no load with other facility equipment.
Can I install a football scoreboard without a contractor?
The electrical work legally requires a licensed electrician in all U.S. jurisdictions. The foundation work typically requires a licensed concrete contractor. The scoreboard mounting itself may be performed by the manufacturer's certified installation team. Attempting to self-perform the electrical work without a license is illegal and will fail inspection.
What is a wind load rating and do I need one for my scoreboard?
A wind load rating is the maximum design wind speed (in mph) the scoreboard structure is engineered to withstand, governed by ASCE 7-22. Most building permit offices require the manufacturer to certify the wind load rating as part of the structural documentation. Coastal and tornado-risk regions have higher design wind speed requirements than inland areas.
What happens if I install a scoreboard without a permit?
Installing without permits exposes the school district to stop-work orders, mandatory demolition, fines, and liability for injury or property damage related to the structure. Insurance coverage is typically voided for unpermitted permanent structures. The permit process is not optional, and most municipalities will not allow an after-the-fact permit for a structure already installed.
How far from the sideline should the scoreboard be placed?
Placement is governed by field safety clearance requirements - typically a minimum of 6 to 10 feet outside the end zone and clear of team bench areas. NFHS guidelines and local facility safety codes should be consulted. Electro-Mech's technical team can advise on siting requirements during the pre-sale process and provide a site layout drawing for permit submission.
AI Summary
